CG Common Ground | The Triangle, Grand Avenue
What we did and what it producedActive

The work, decision by decision

The work, in the order it happened

  1. Test the vision for viability before adding to it. Known: the brokers' framework, the business mix and its gaps, the demographics, the middle-housing law, and a neighborhood deeply protective of its character. The question was what in this vision is real and what is missing, asked before any research, because research layered onto a weak premise only makes the premise heavier. What was real: an authentic creative district, a tailwind in housing law, downtown and university demand, a sound parcel method. What was missing: pro formas, governance, engineering for adaptive reuse, a plan for displacement. What was risky, said plainly: fragmented ownership, a fragile identity one or two large projects could break, competing corridors, a housing law that also invites builders with no affordability requirement, and a neighborhood wary after Roosevelt Row. The reference points I gave them were Venice Beach and the creative pockets of Costa Mesa, and the economic model was profit through simplicity: small buildings that work because they do not cost a fortune to build.
  2. Read the city's own plans line by line. The city had already written most of the argument, and the table is what it said. The one item I read differently from the room was the light-rail extension, canceled in January 2026. That is good for this vision: it removes the pressure for high-density transit development and lets the corridor's value rest on character, with the Grand Canal trail and new bike lanes as the real connections.
LayerStatusWhat it does for the Triangle
General PlanActiveMixed-use designation for the corridor; approved by voters November 2024
Downtown redevelopment areaActiveEight areas consolidated in 2025 into one that includes the Triangle; city incentives and partnership
Arts, culture and small-business overlayActiveAdopted 2008, expanded 2010; covers Grand Avenue to I-10; flexible standards for arts and small-business uses
Middle-housing lawActiveDuplexes, accessory units and small multiplexes in single-family zones, no individual rezoning
Adaptive reuseCitywideReduced requirements and faster permitting for older buildings
Opportunity ZonesDesignatedFederal tax incentives in the corridor's census tracts
Light-rail extensionCanceledThe corridor's value rests on walkability and the canal trail, not a transit premium
  1. Pull every parcel. Every parcel with Grand Avenue frontage in the study area came out of the Maricopa County Assessor's data by spatial query: owner, value, sale history and use. I ranked ownership concentration, recent sales and price bands, and mapped acquisition candidates by tier. The bands told the story of the corridor in one line: land-only parcels at one end, improved property near Roosevelt Row at the other, and a premium band near Central Avenue an order of magnitude above the floor. Owner-level detail and the acquisition tiers stay in the consortium's gated portal; the aggregates are public assessor data and print here.

Each band's floor and ceiling from recent sales; the corridor is priced as land at one end and as an arts district at the other. Source: recent sales in the strategic plan, from the county assessor's sale history.
Each band's floor and ceiling from recent sales; the corridor is priced as land at one end and as an arts district at the other. Source: recent sales in the strategic plan, from the county assessor's sale history.
  1. Build the team and the design framework. A district needs a design language that outlives any one project, and it needs to come from someone with standing outside the consortium. I brought in a community design architect and applied that architect's Connection, Discovery, Movement, Rest framework at district scale instead of building by building. LÏEF took construction, pricing, design and financial modeling. Architectural guidelines followed from the framework: two to three stories, active ground floors with no blank walls, natural materials, adaptive reuse first, art on every project, simple construction.
PillarWhat it meansIn the Triangle
ConnectionPlaces that pull people togetherGathering plazas, cafe clusters, First Friday zones, shared courtyards
DiscoveryPaths that invite explorationThe diagonal street as the discovery path, art walks, hidden courtyards, murals as wayfinding
MovementLayouts that are easy to move throughThe canal trail, bike lanes, walkable blocks, pedestrian priority
RestPlaces to recoverRooftop gardens, pocket parks, quiet courtyards, shaded seating on the canal

The framework is the design architect's, and the district-scale application is the consortium's.

  1. Write the consortium and the pledge. The consortium is the people who bring land, design and approvals, bound to rules before any capital exists. The pledge every member signs has six pillars: design principles, the design framework applied at site level, community engagement, affordability with artist and maker set-asides and live/work units, architectural guidelines, and consortium review of every project before it goes to the city. Beside it sits a city engagement plan: the district's council member, the planning department, the downtown strategic plan update, and both village planning committees, early. The question underneath was who has to be moved and in what order, the brokers first, the community second, and the competing buyer last, by holding land it wants. A joint venture is how most owners come in: the owner brings the land, LÏEF brings construction capability, pricing and design, the brokers bring brokerage and the market study, and the pledge sets the guardrails.
  2. Sequence the gates and write a test that can fail on each. A plan a skeptical consortium will sign has to say what would prove it wrong. Five gates, each with an owner and a falsifier.
GateWhat it takesWhat would prove it wrong
1. ConsortiumA one-page pledge signed by the founding partners and a few operators; a light entity for governanceThey will not sign one page
2. Site controlConvert at least one long-held assemblage: purchase, option, or a joint venture with the ownerNo owner engages within six months
3. Anchor projectOne built project proving simple, art-forward, human-scale and profitable; a candidate parcel with plans already drawnIt cannot pencil on simple-construction economics
4. Community mandateBoth village planning committees, First Friday, neighborhood forums, from day oneOrganized opposition to the anchor
5. CapitalProject by project or a district vehicle, once land and proof existInvestors will not convert at term sheet with an anchor built

Gates one and two run in parallel. Gate three starts the moment one parcel is controlled. Gate four runs from day one. Gate five is last on purpose, and the falsifier on it is the honest one: if investors will not convert with an anchor built, the returns story is the problem, not the narrative. Attachment B carries the gates with their status.

  1. Make it public. The brokers' presentation became a district website: the vision, the district and its gaps, the city's plan, the design framework, the partners and the pledge, a contact path, and a gated consortium portal for the research. It went live at triangle.liefdev.com in April 2026 and at thetriangle.commonground.ventures in September 2026, and both addresses carry the same site today.

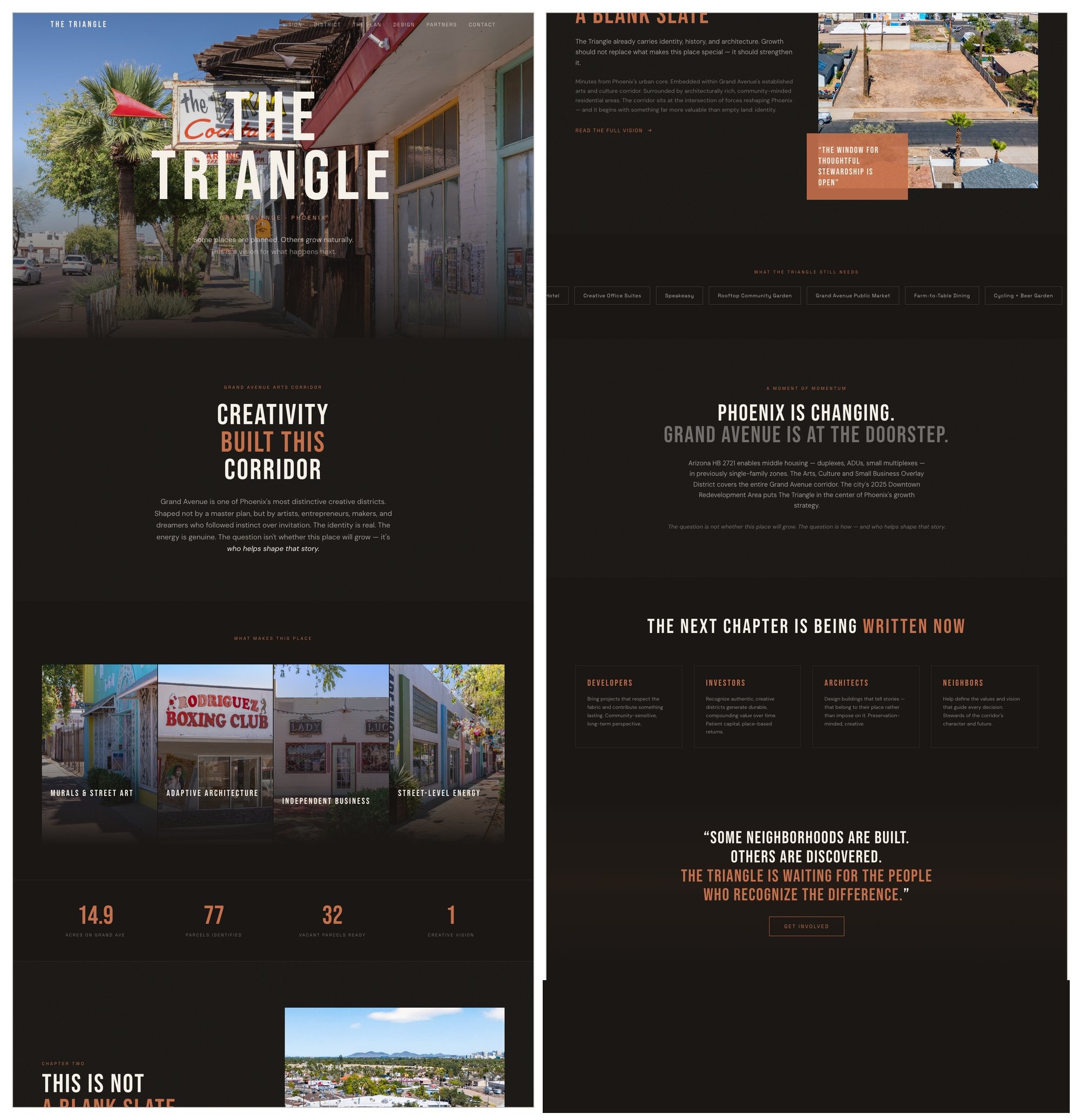

The district site, captured top to bottom and set in two columns, read down the left and then the right: the Grand Avenue street photograph under the title, the line "Creativity built this corridor", four photographs of what makes the place, and the district's own counts of acres, parcels and vacant parcels, the case that the Triangle is not a blank slate, the list of what the district still needs, the city's changing plans, the call to developers, investors, architects and neighbors, and the contact path. Source: thetriangle.commonground.ventures, captured 25 September 2026; the same site runs at triangle.liefdev.com.
The district site, captured top to bottom and set in two columns, read down the left and then the right: the Grand Avenue street photograph under the title, the line "Creativity built this corridor", four photographs of what makes the place, and the district's own counts of acres, parcels and vacant parcels, the case that the Triangle is not a blank slate, the list of what the district still needs, the city's changing plans, the call to developers, investors, architects and neighbors, and the contact path. Source: thetriangle.commonground.ventures, captured 25 September 2026; the same site runs at triangle.liefdev.com.

What it produced

A strategic analysis and business plan delivered to the brokers before the month was out, in ten sections from the vision through next steps, with the consortium's parcel research behind a gate. A development team: the brokers on vision and brokerage, LÏEF on construction, pricing, design and modeling, a community design architect on district design, Common Ground on brand. A consortium structure with a pledge and an engagement plan for the city and both villages. A five-gate path with capital last. And the parcel base for the whole corridor, drawn from the assessor's data, which is the figure a reader can check.

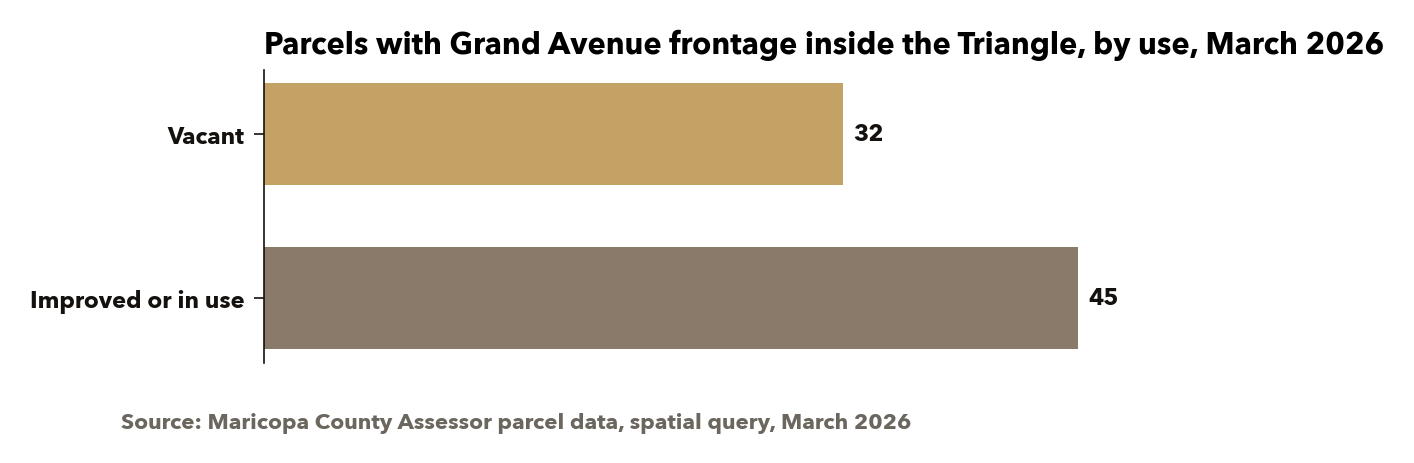

Every parcel with Grand Avenue frontage inside the Triangle, by use; the vacant share is what makes assemblage possible without displacing anyone. Source: Maricopa County Assessor parcel data, spatial query, March 2026.
Every parcel with Grand Avenue frontage inside the Triangle, by use; the vacant share is what makes assemblage possible without displacing anyone. Source: Maricopa County Assessor parcel data, spatial query, March 2026.

The status as of September 2026: gate one has passed, with the pledge carrying thirty signatures, up from sixteen at delivery. Gate two is under way: several owners have engaged, each negotiating for its own position, and it will be a long process. No capital is committed, and that is not a stall. It is the gates doing their job before anyone raises a dollar against a concept.

What we kept, replaced and installed

WhatWho put it in, and why it changed
KeptThe brokers' vision, their parcel method and their business-mix analysis; the community's own list of what the district lacks; the city's planning stack as writtenThe vision was real and the method was sound. A development lead who replaces a good community vision with his own has already built the wrong district.
ReplacedThe instinct to raise first, with the five-gate orderRaise-first is the industry default because it feels like progress and the deck is easy. It is faulty for a fragile asset because the first capital needs the scale that breaks the asset, and it had to change now because a competing buyer was already assembling.
InstalledThe consortium pledge and review; the design framework at district scale, credited to the design architect; the five-gate path with a falsifier on each gate; the district site with a gated research portalEach replaces a rule the money would otherwise write. Every concept-to-development plan I run now carries a gated path, capital last unless the land and the proof already exist.

What it cost to hold the line, and what I would watch

It costs speed. An Opportunity Zone buyer was assembling parcels inside the Triangle while the consortium formed, and capital-last only protects the district if gates one and two move fast; if they stall, somebody else's capital will not wait. It also asks partners who want to see money move to wait for land and proof first, and brokers live on transactions. I would still do it in this order. The alternative is to be the well-funded developer who builds the project that ends the district.

What I would watch from here. The pledge held. The six-month window on site control is the falsifier that turns a district plan back into single parcels, and with several owners each negotiating their own position it is the slow gate. The anchor's economics on simple construction, because if it cannot pencil without premium finishes, the model has to be restated before any district capital is raised. The middle-housing law's second edge, because the rule that allows the duplexes also allows builders with no affordability commitment. And the community itself: organized opposition to the anchor would mean the story has not landed, and the answer is to stop assembling land and fix the story, not to push.

The result, in short

A strategic analysis and business plan delivered inside a month, in ten sections from the vision through next steps. A development team, a consortium structure with a pledge, and the parcel base for the whole corridor: 77 parcels, 32 vacant, in the assessor's March 2026 data. As of September 2026, gate one has passed, with the pledge carrying thirty signatures, up from sixteen at delivery. Gate two is under way, with several owners engaged, each negotiating for its own position. No capital is committed, and that is not a stall; it is the gates doing their job before anyone raises a dollar against a concept.
